The percentage of completion method is a revenue recognition accounting concept that evaluates how to realize revenue periodically over a long-term project or contract. Revenue, expenses, and gross profitGross ProfitGross profit is the direct profit left over after deducting the cost of goods sold, or cost of sales, from sales revenue. It's used to calculate the gross profit margin. are recognized each period based on the percentage of work completed or costs incurred.



Percentage of Completion Method: Accounting Explained



Understanding the Percentage of Completion Method

The percentage of completion method falls in-line with IFRS 15, which indicates that revenue from performance obligations recognized over a period of time should be based on the percentage of completion. The method recognizes revenues and expenses in proportion to the completeness of the contracted project. It is commonly measured through the cost-to-cost method.



There are two conditions to use the percentage of completion method:

  1. Collections by the company must be reasonably assured.
  2. Costs and project completion must be reasonably estimated.



Journal Entries: Percentage of Completion Method

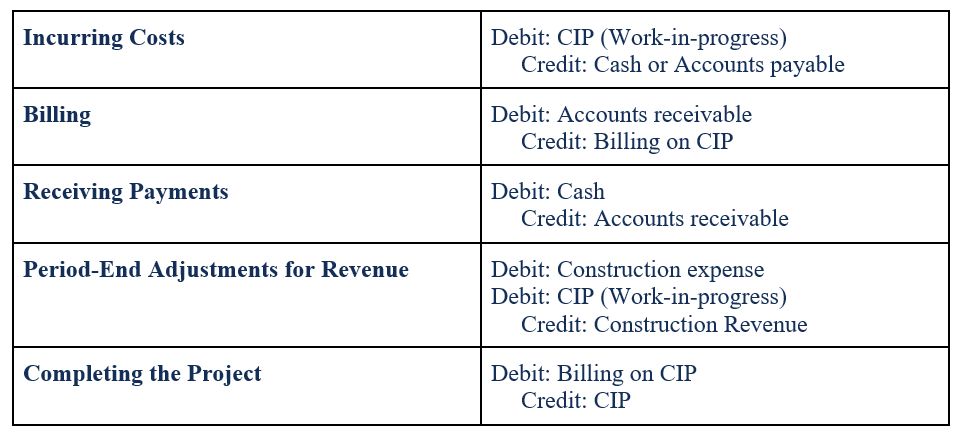

Journal entriesJournal Entries GuideJournal Entries are the building blocks of accounting, from reporting to auditing journal entries (which consist of Debits and Credits) for the percentage of completion method are as follows:



Percentage of Completion Method: Accounting Explained



Cost-To-Cost Approach

In the cost-to-cost approach, the percentage of completion is based on the costs incurred to the estimated total cost to complete the project. Therefore, the equation for the cost-to-cost estimate of percentage completion is:

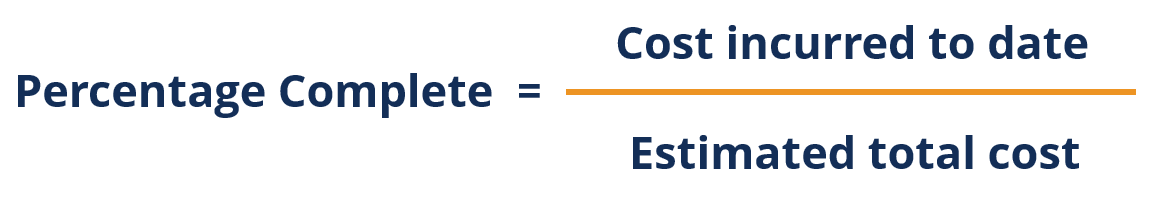

Percentage complete:



Percentage of Completion Method: Accounting Explained

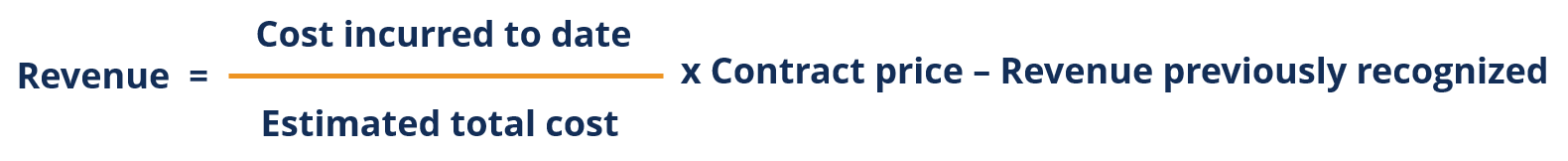

Revenue recognized:



Percentage of Completion Method: Accounting Explained



An example is provided below to clarify the cost-to-cost approach.



Example of the Cost-To-Cost Approach

StrongBridges Ltd. was awarded a $20 million contract to build a bridge. The estimated time to complete the project is three (3) years, with an estimated cost of $15 million. Assuming that the cost estimates do not change, the project is expected to generate $5 million in profitProfit ModelA profit model refers to a company’s plan that aims to make the business profitable and viable. It lays out what the company plans to manufacture, how. The following is a schedule on the project:

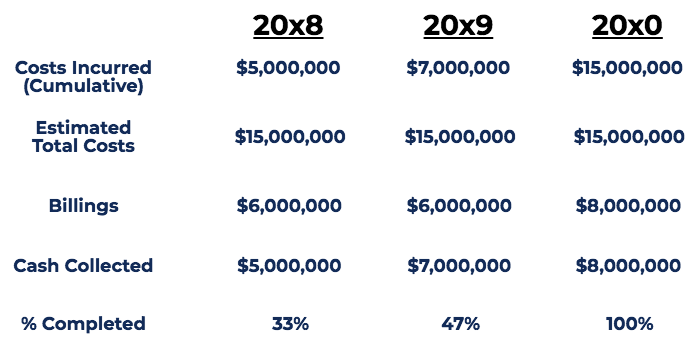

Percentage of Completion Method: Accounting Explained



Notes:

  • Costs Incurred is the costs incurred to build the bridge as estimated by the company’s engineer.
  • Billings are the amount of money StrongBridges Ltd. billed for the construction of the bridge. Billings amount is set by the contract.
  • Cash Collected is the amount of money StrongBridges Ltd. received for the construction of the bridge. The variation in billings and cash collected is due to timing differences.
  • % Completed is determined by the percentage completion formula.



For the schedule above, revenues recognized under the percentage of completion method:

  • Year 2008: 33% completed. Revenue recognized = 33% x $20 million (contract price) = $6,600,000
  • Year 2009: 47% completed. Revenue recognized = 47% x $20 million (contract price) – $6.6 million (previously recognized) = $2,800,000
  • Year 2010: 100% completed. Revenue recognized = 100% x $20 million (contract price) – $6.6 million – $2.8 million (previously recognized) = $10,600,000

Total Revenue = $20,000,000



Costs recognized under the percentage of completion method:

  • Year 2008: $5,000,000
  • Year 2009: $2,000,000
  • Year 2010: $8,000,000

Total Cost = $15,000,000



Profit recognized under the percentage of completion method:

  • Year 2008: $6,600,000 – $5,000,000 = $1,600,000
  • Year 2009: $2,800,000 – $2,000,000 = $800,000
  • Year 2010: $10,600,000 – $8,000,000 = $2,600,000

Gross Profit = $5,000,000



Journal entries for the example above would be as follows:



Percentage of Completion Method: Accounting Explained
